REBUILDING ST CHARLES COLLEGE
Glory and praise to the Almighty God, who by His grace, our school; St. Charles College Abavo have been favored with a benefactor, who has promised to transform her face as he has done to many schools. As we continue to make progress on our project, we are pleased to provide an update on the current status of the development.
Below is an overview of the key milestones achieved to date and the next steps in our project timeline.
Current Status:
The tankstand has been successfully constructed and erected, with four GP tanks installed on it. The installation of solar panels to power the Sumor Solar sumper has also been completed.

In addition, the moulding of blocks is ongoing, with 15,000 blocks already produced. The moulding of the final batch of 15,000 blocks is currently in progress.
Next Steps:
According to our contractor, the digging of the foundation will commence as soon as the block moulding is completed. We look forward to sharing further updates on our project progress in the coming weeks.
REV. FR . VICTOR OFILI
NEW MILESTONE IN THE BUILDING DEVELOPMENTS

Front View Administrative Block

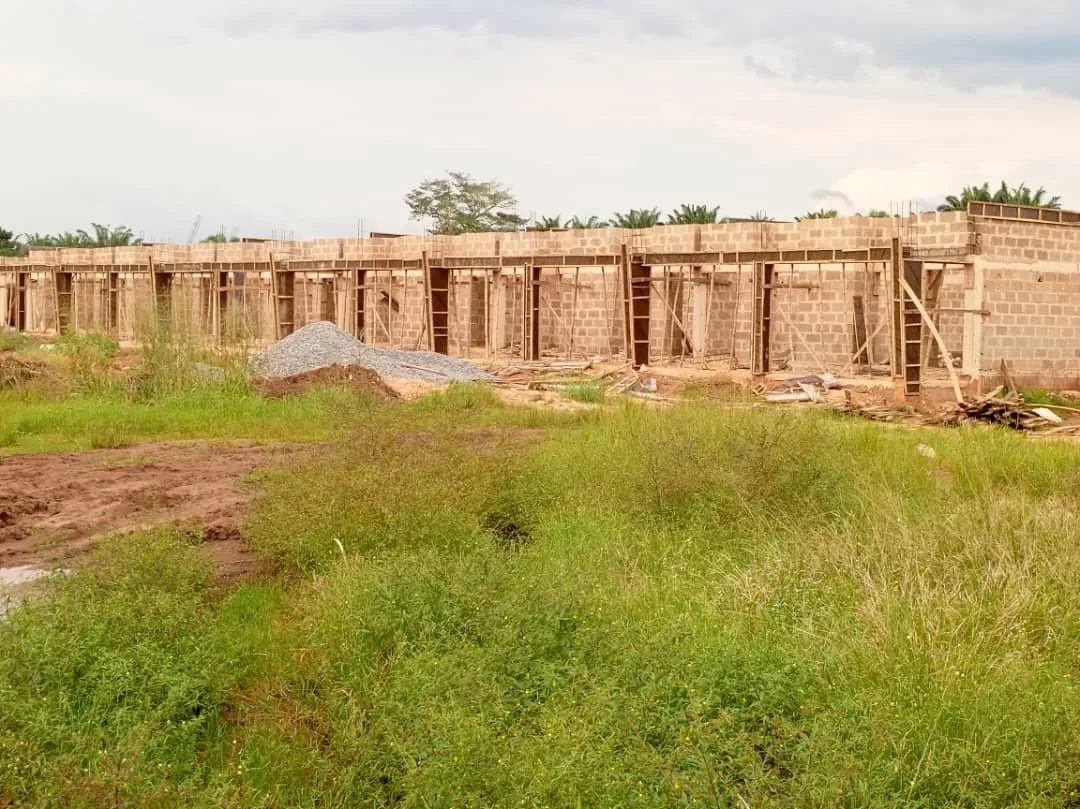

The class after Library, boarded for concrete base for the roof.

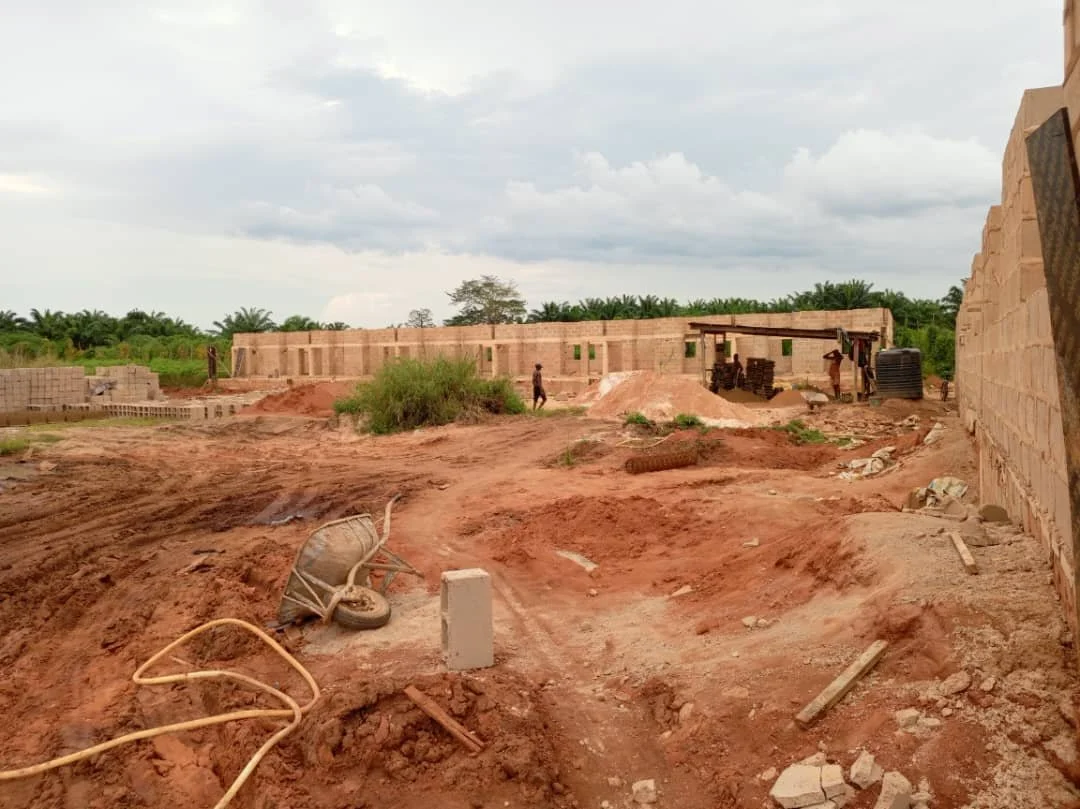

Second Class Block along the Library
Science Laboratory Block above foundation level
Front View Administrative Block

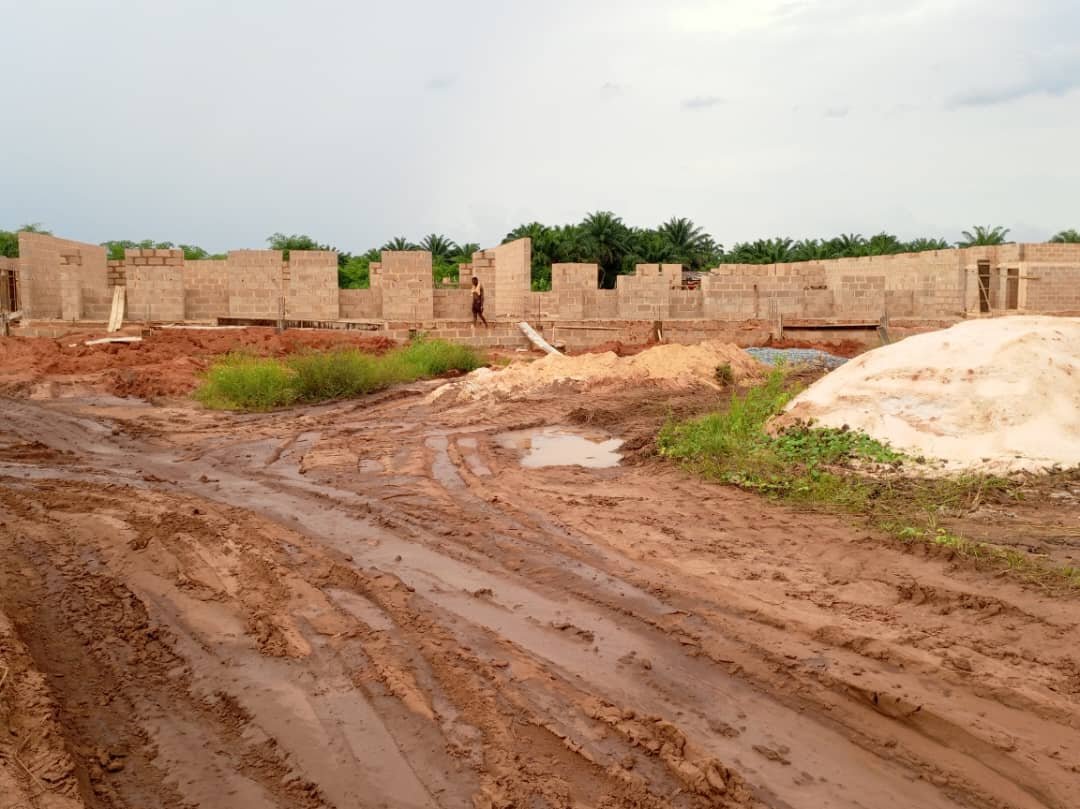

ICT and Home Economics Block

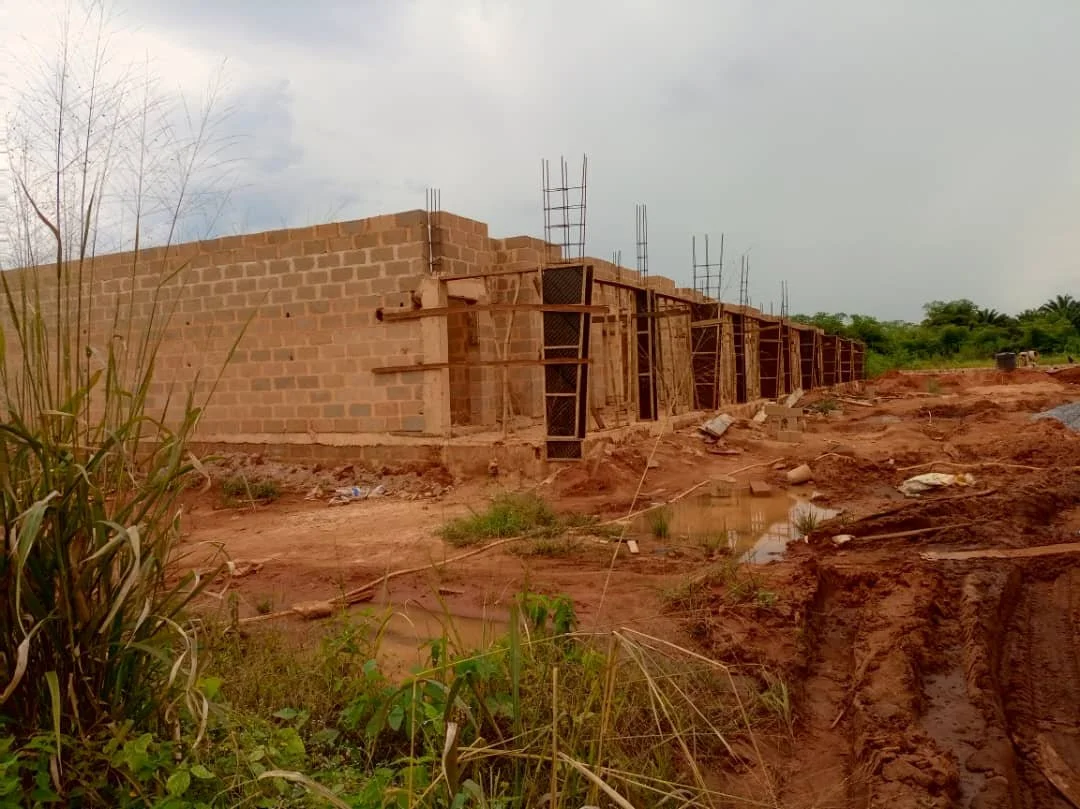

Second Class Block opposite the Library
Science Laboratory Block above foundation level

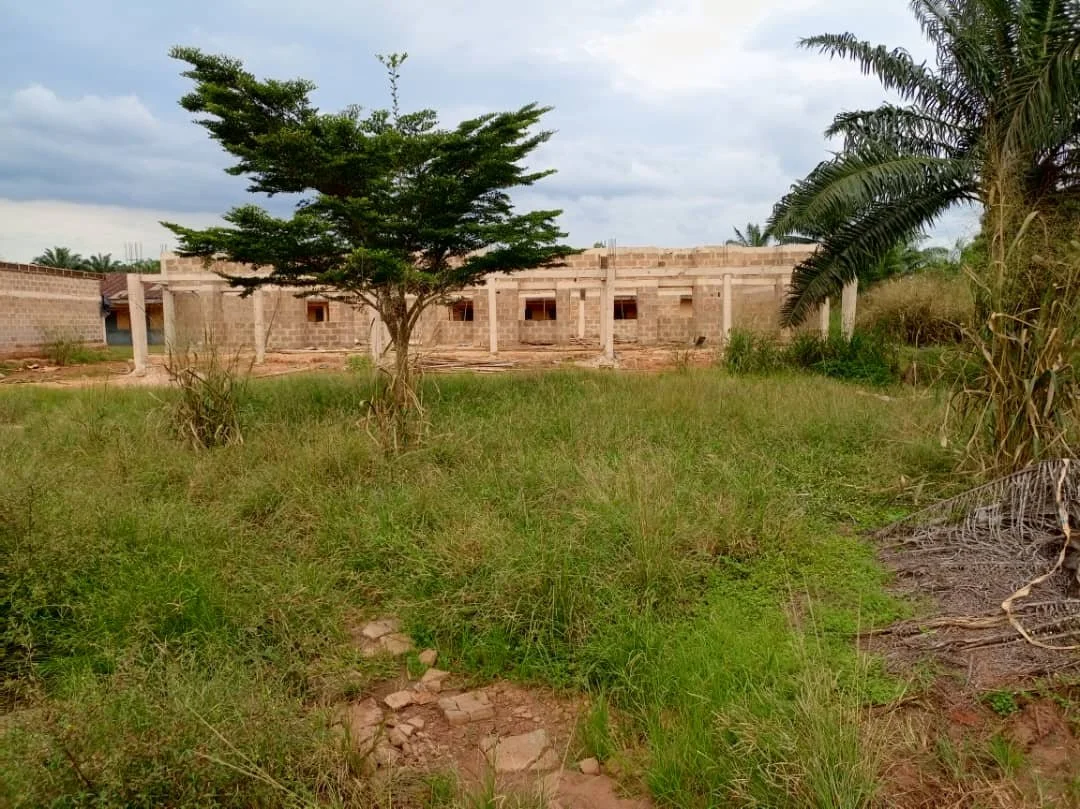

Library Block Awaiting Roofing

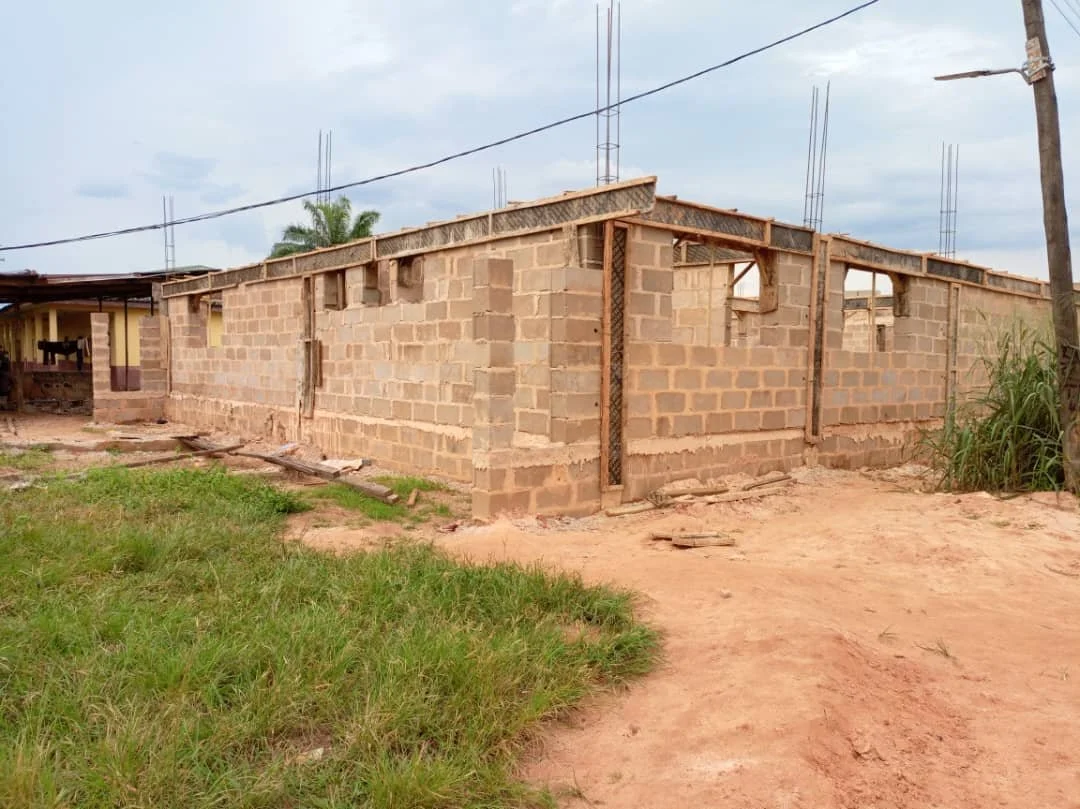

Side View Administrative Block

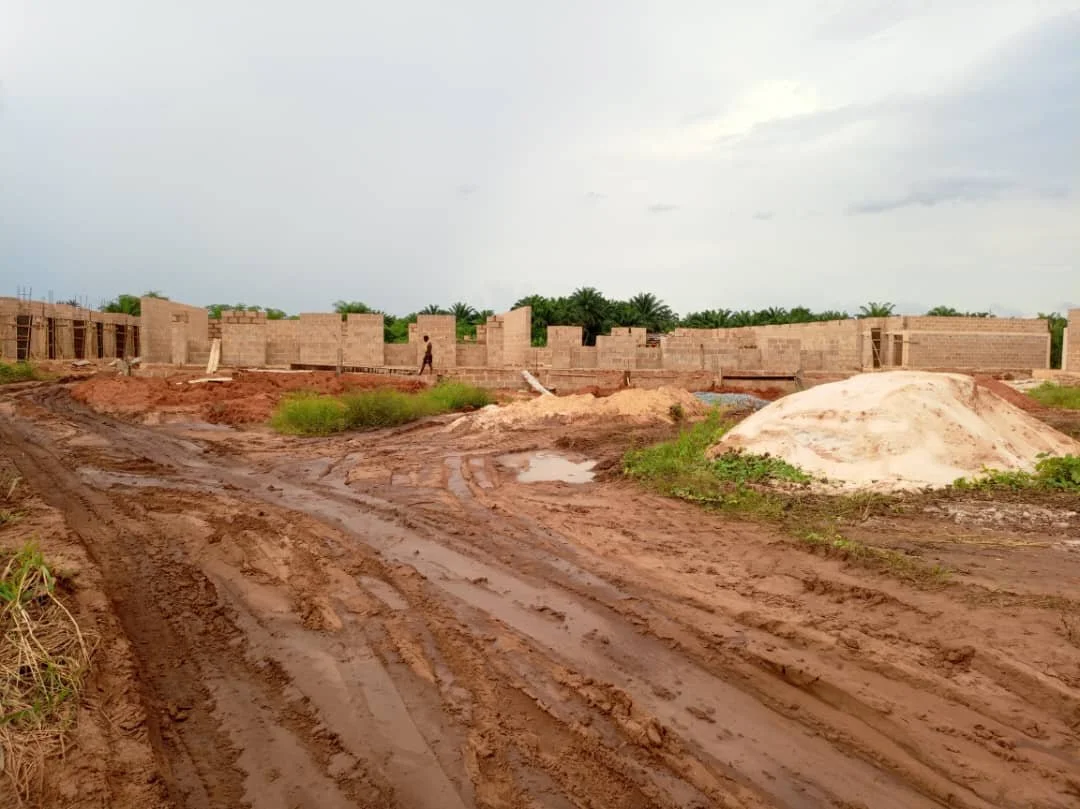

ICT and Home Economics Block passes window level.

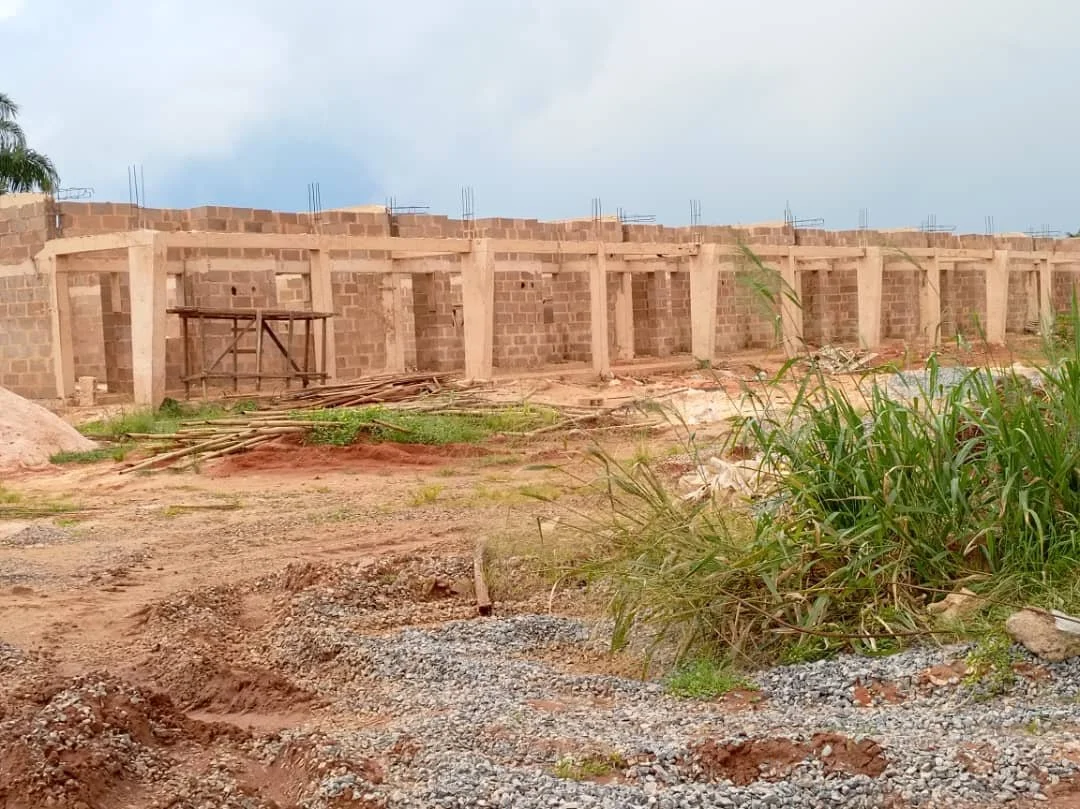

First Class Block opposite the Library

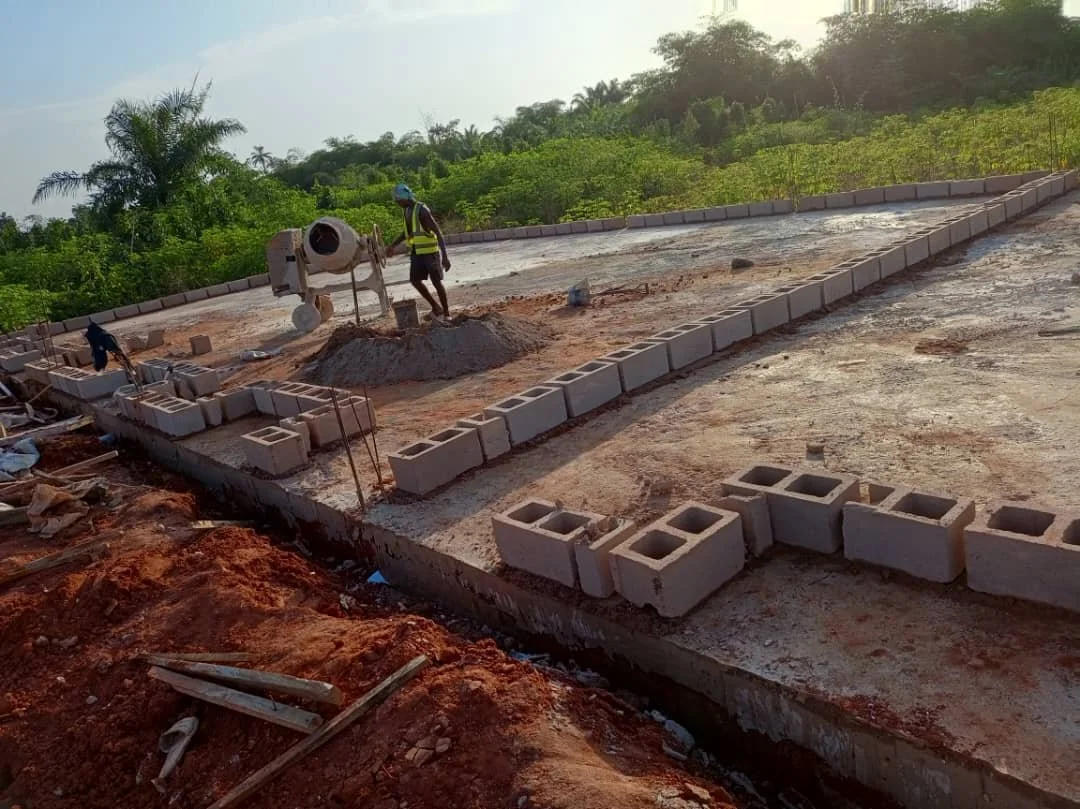

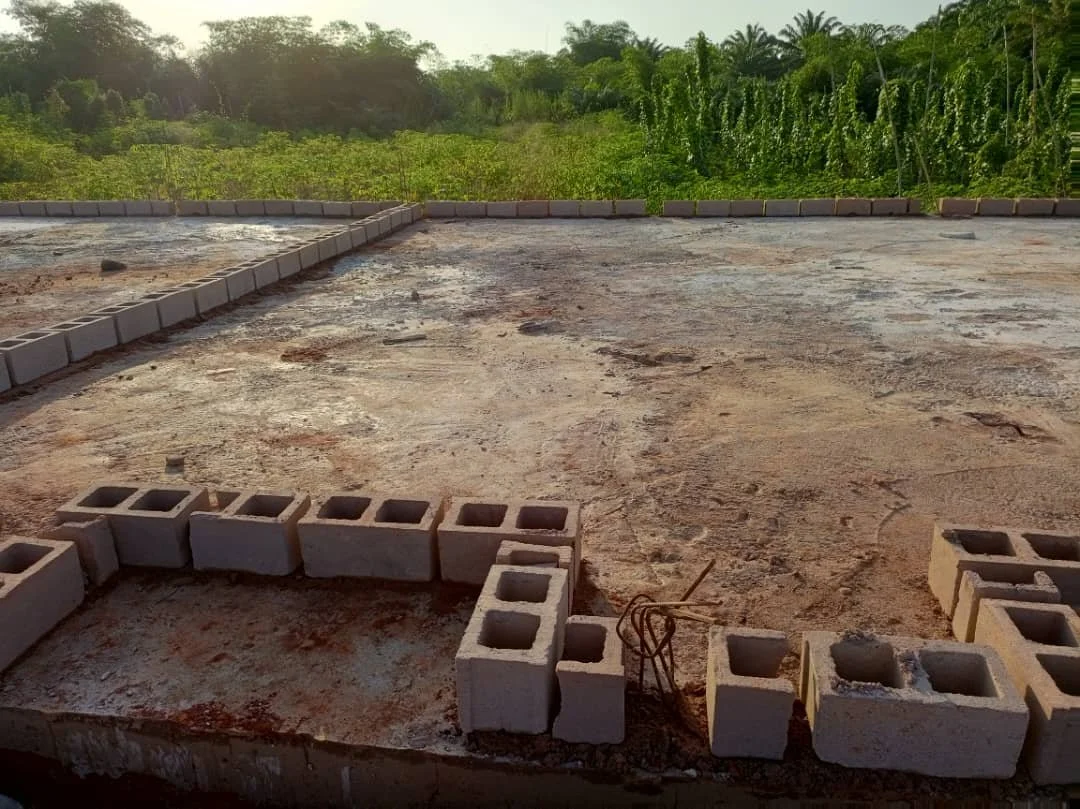

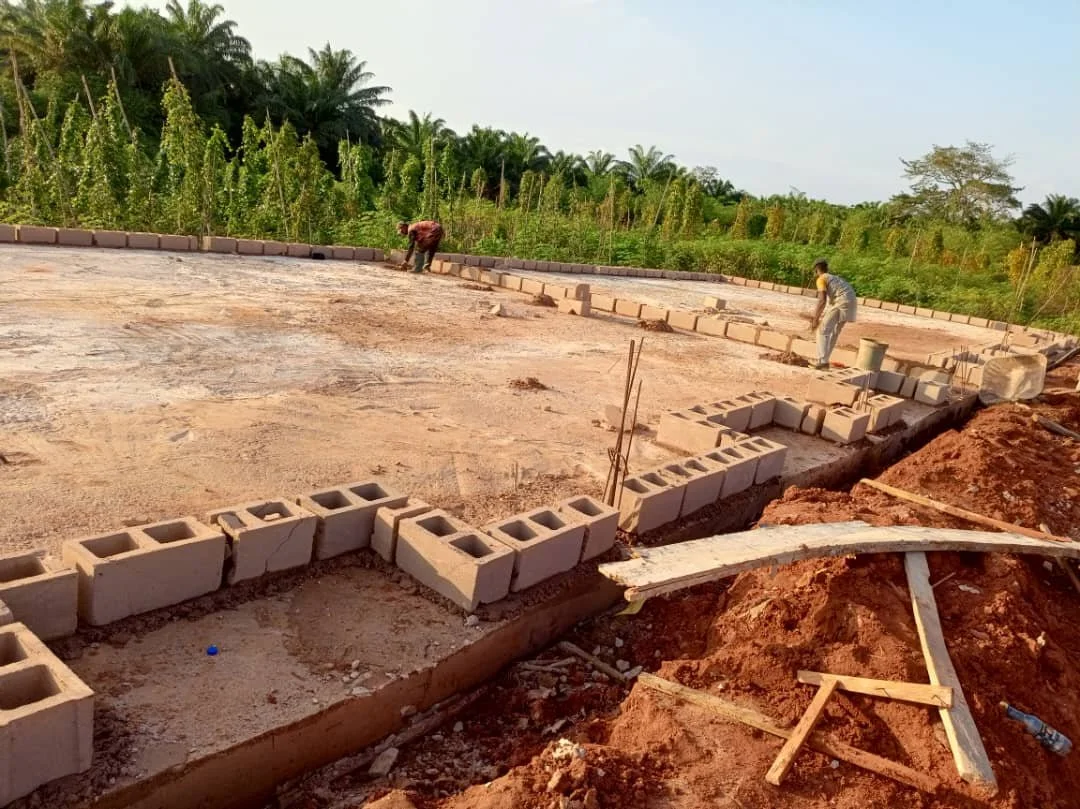

Science Laboratory Block above foundation level

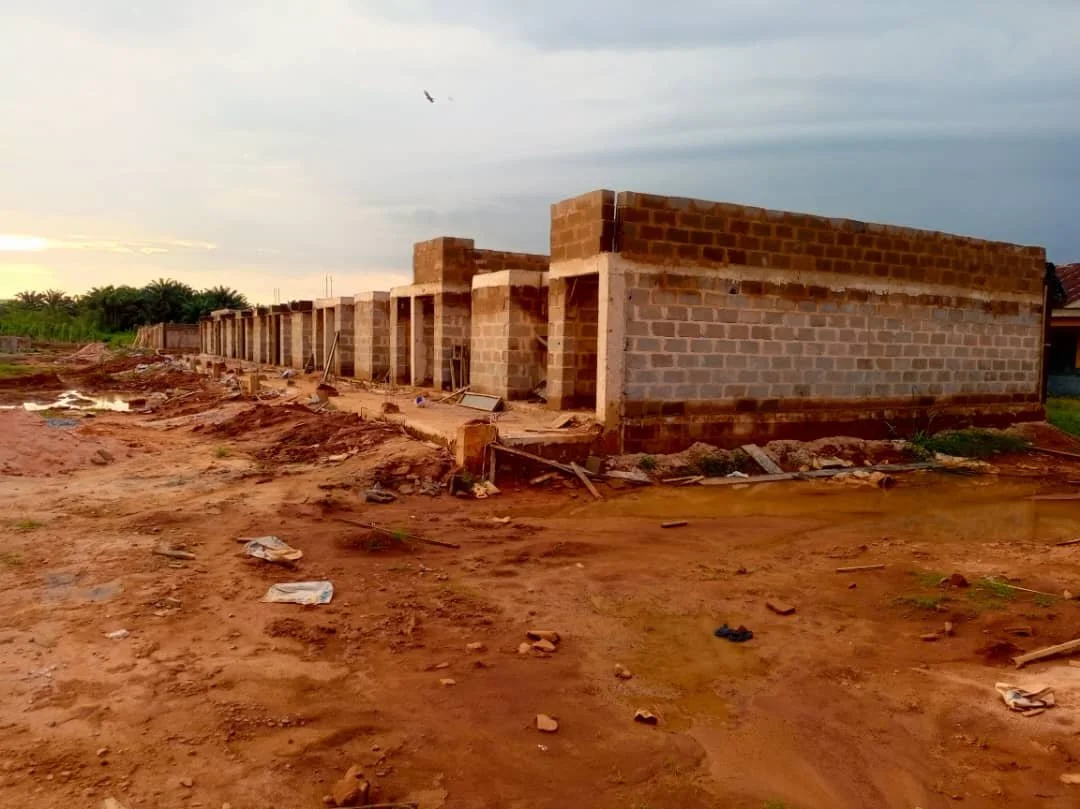

First block of six classrooms lintel work completed, blocks to roofing level being added.

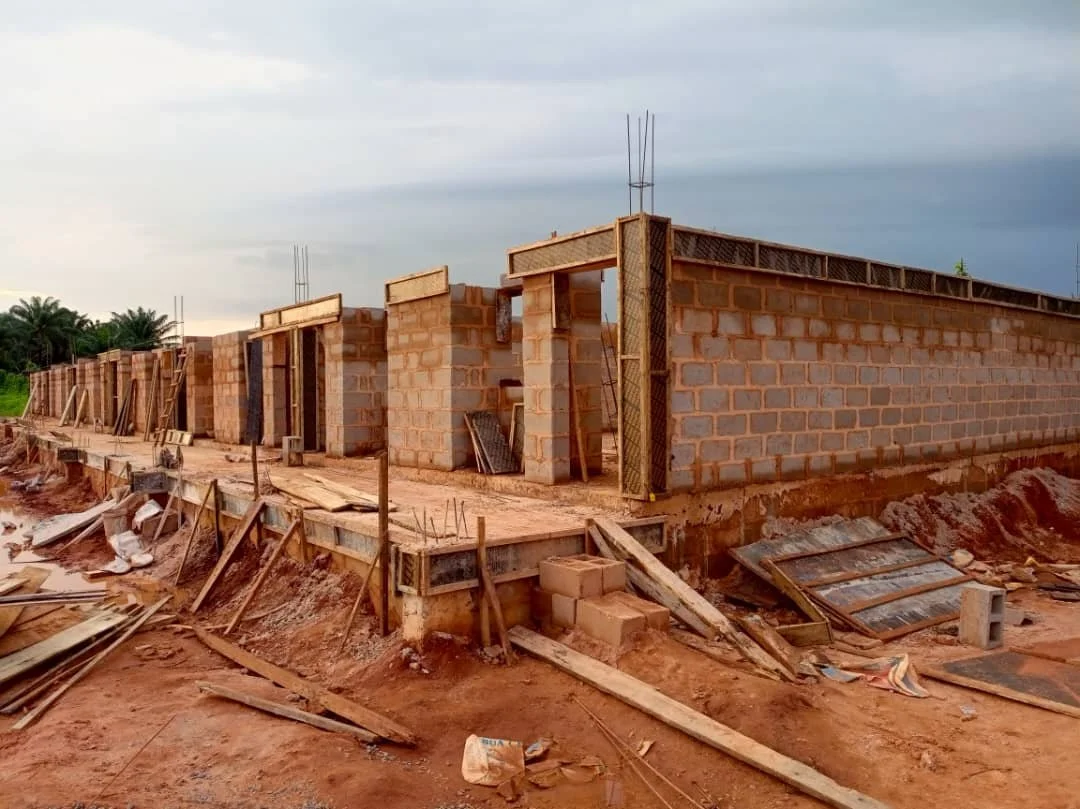

Second block of six classrooms being boarded for lintel.

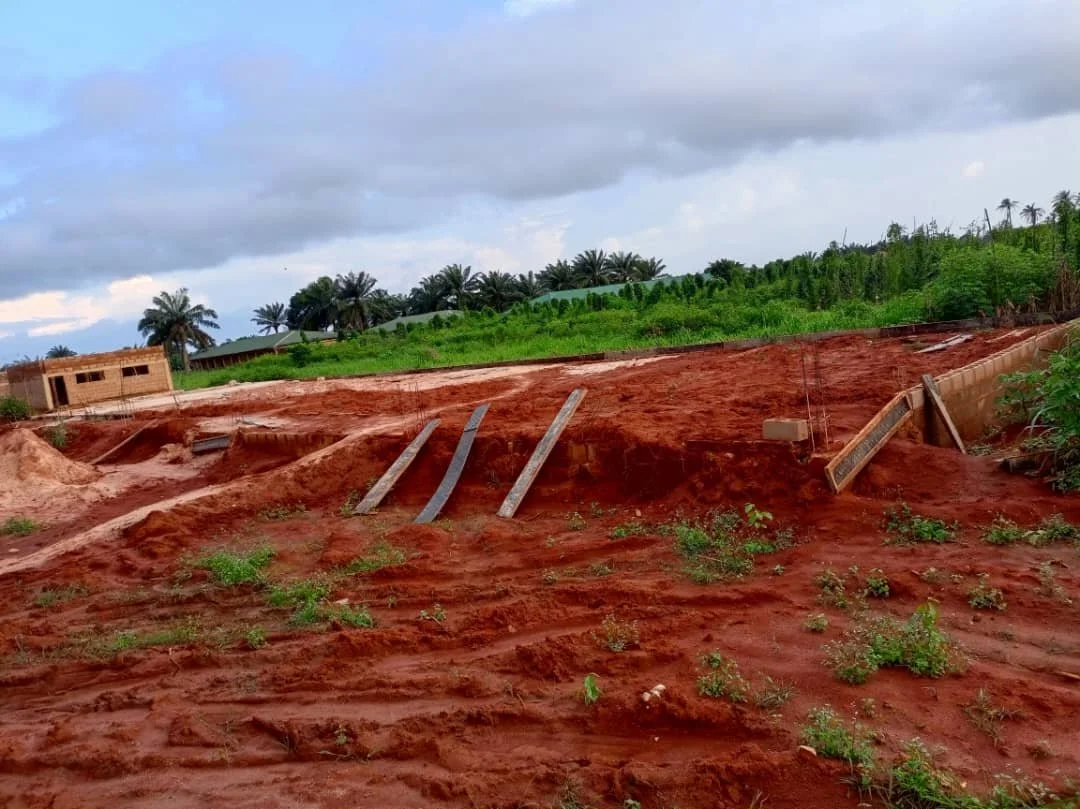

Second block of six classrooms by the left of the school main gate undergoing floor casting.

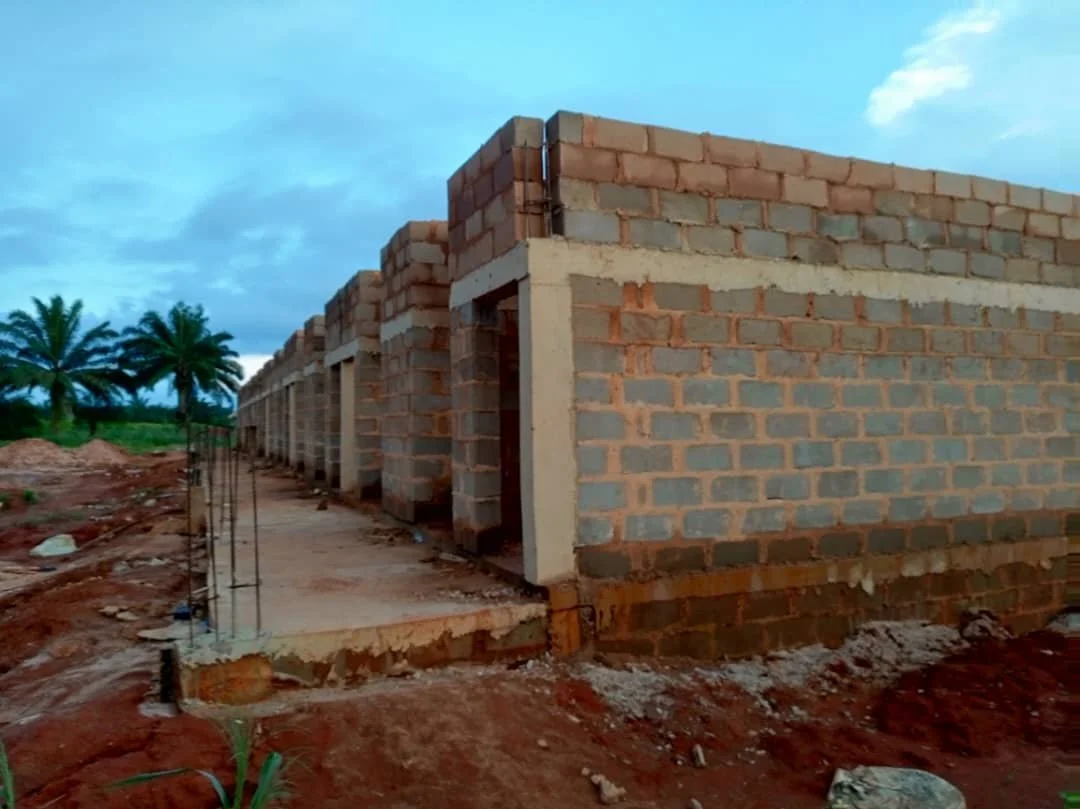

First block of six classrooms from the left,. Block works completed. Awaiting the erecting of the pillars.

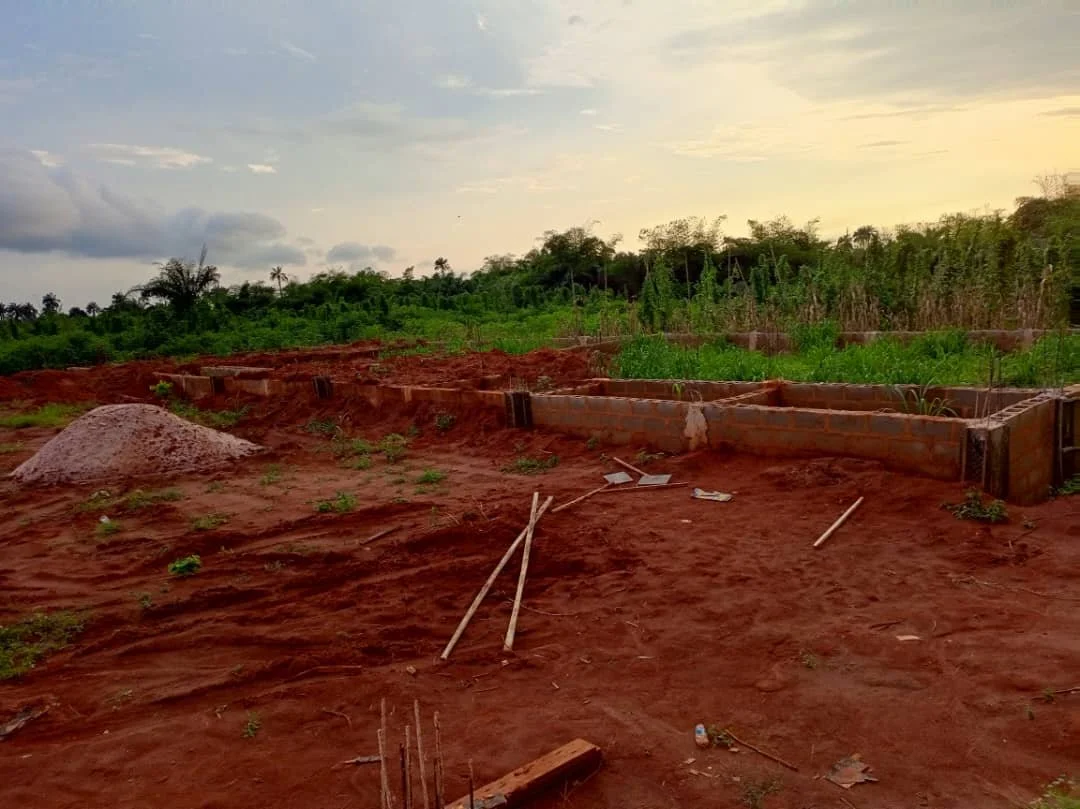

The laboratory block still at foundation level because of the swampy soil and rain that hampered movement of the materials too close to it.

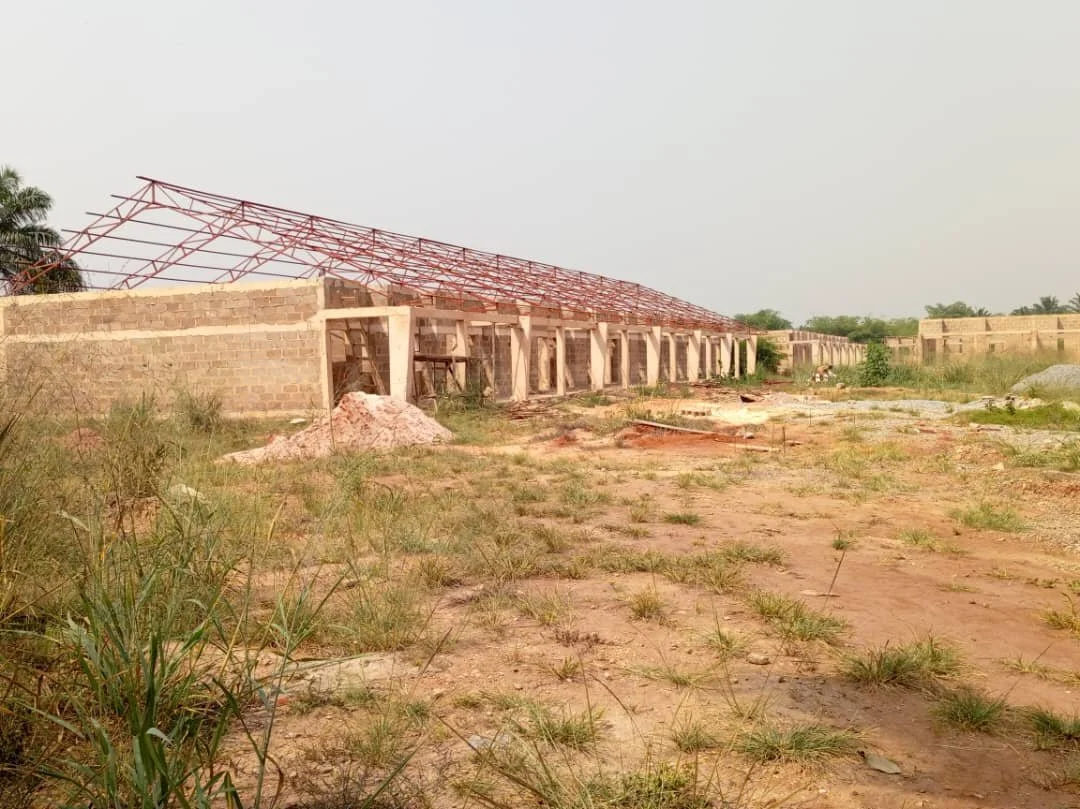

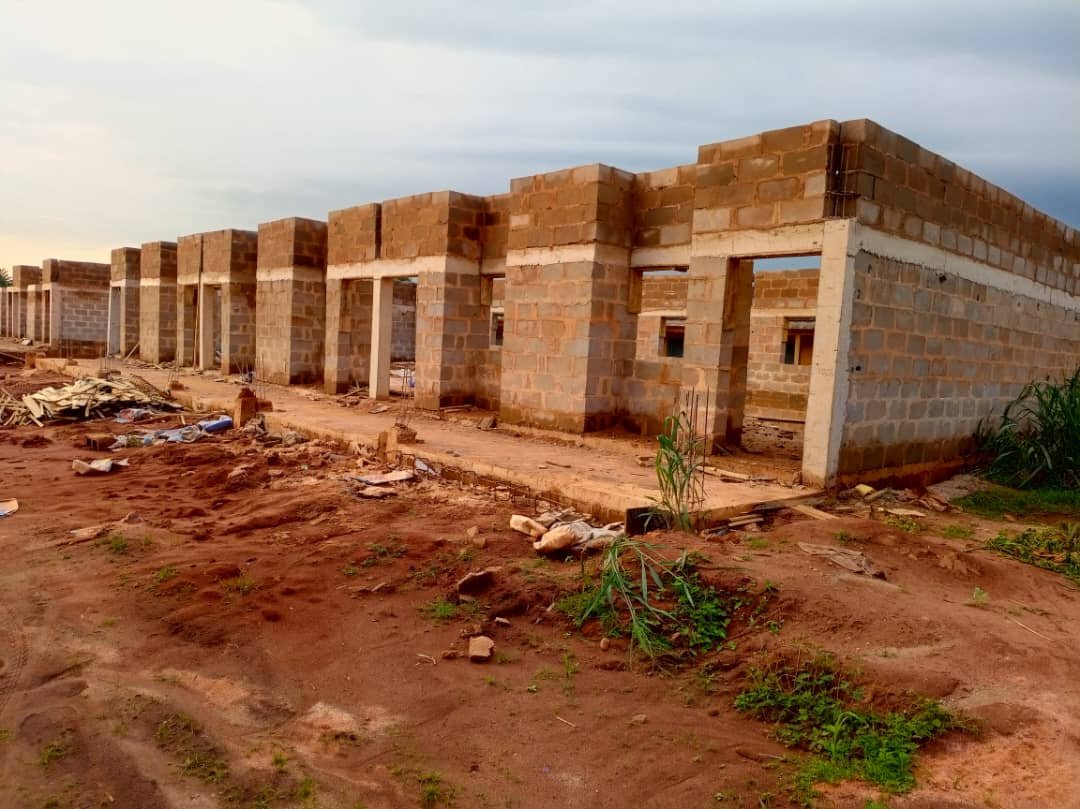

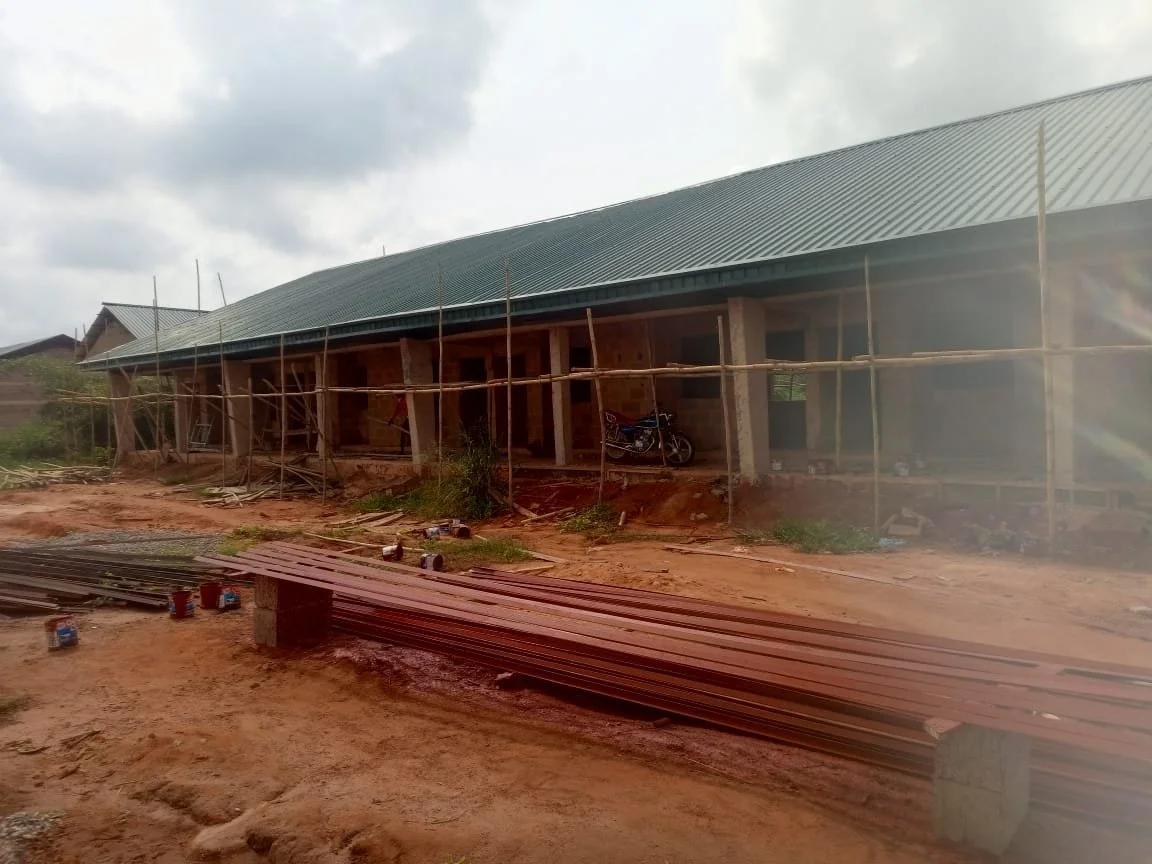

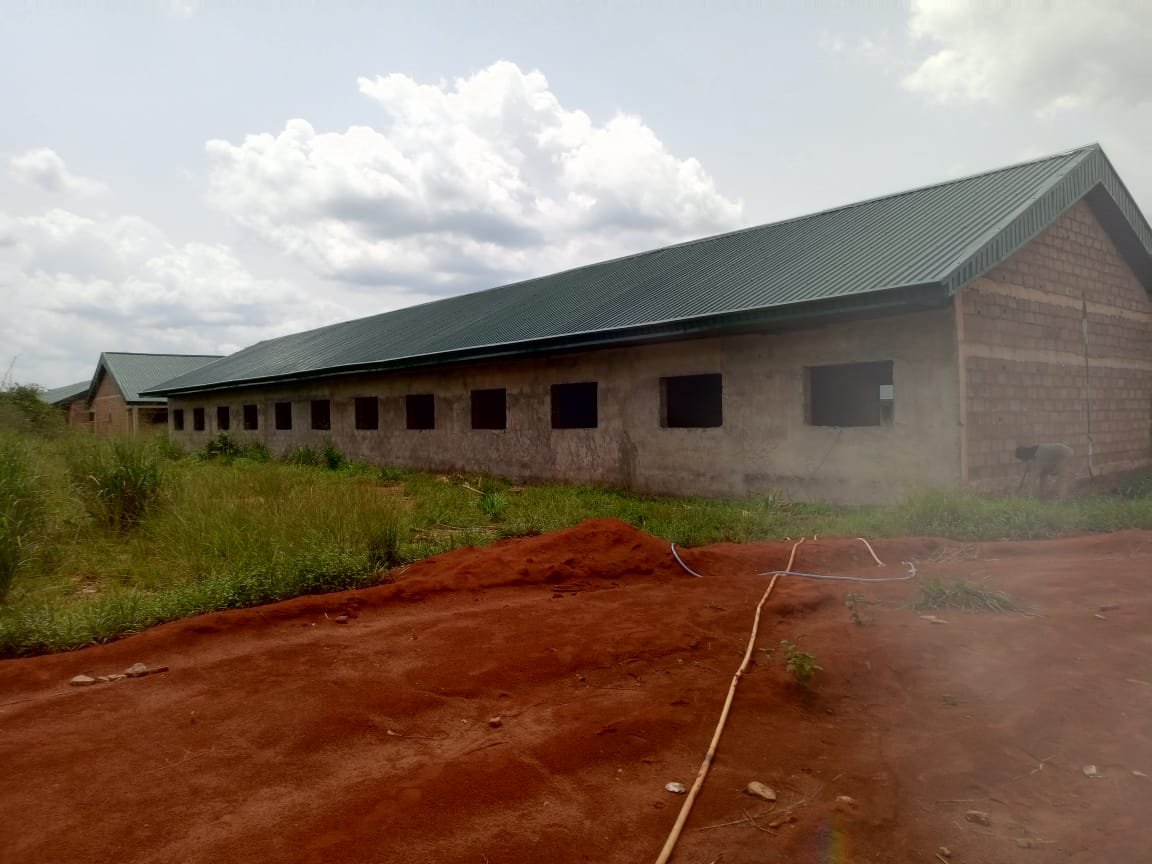

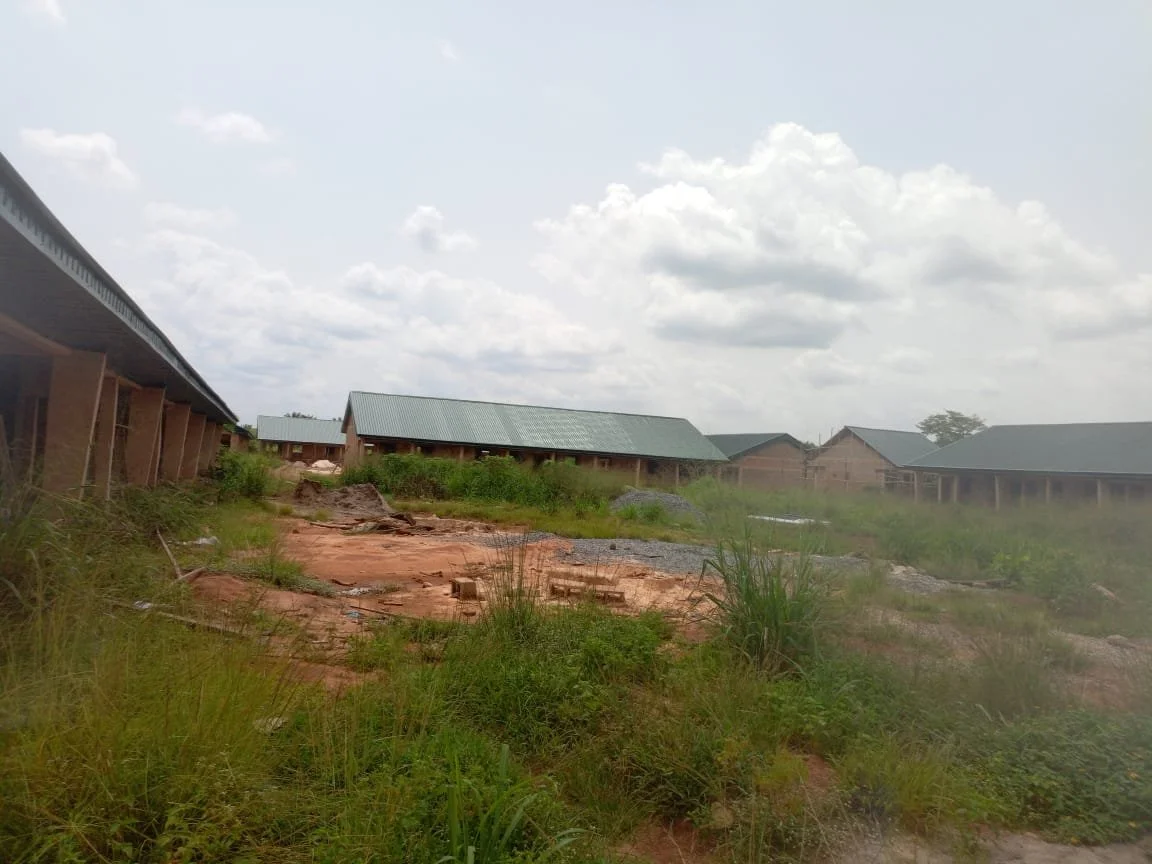

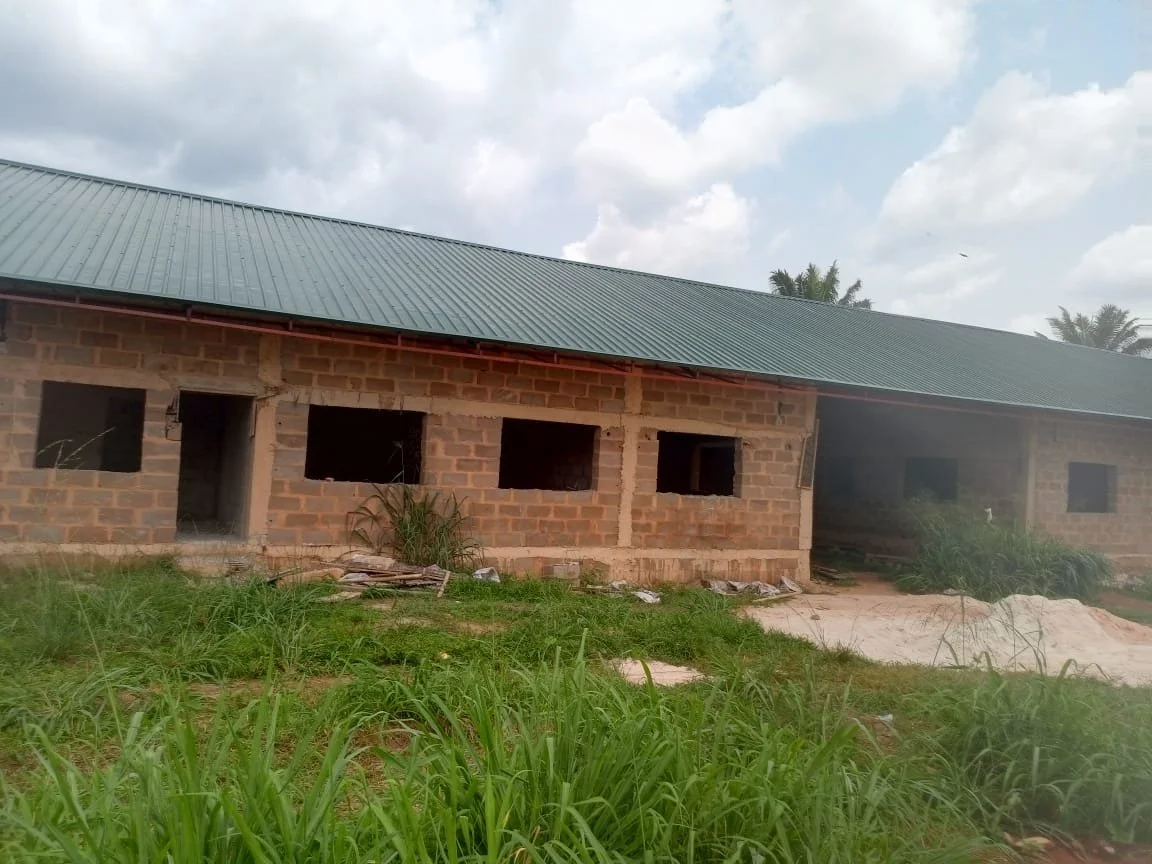

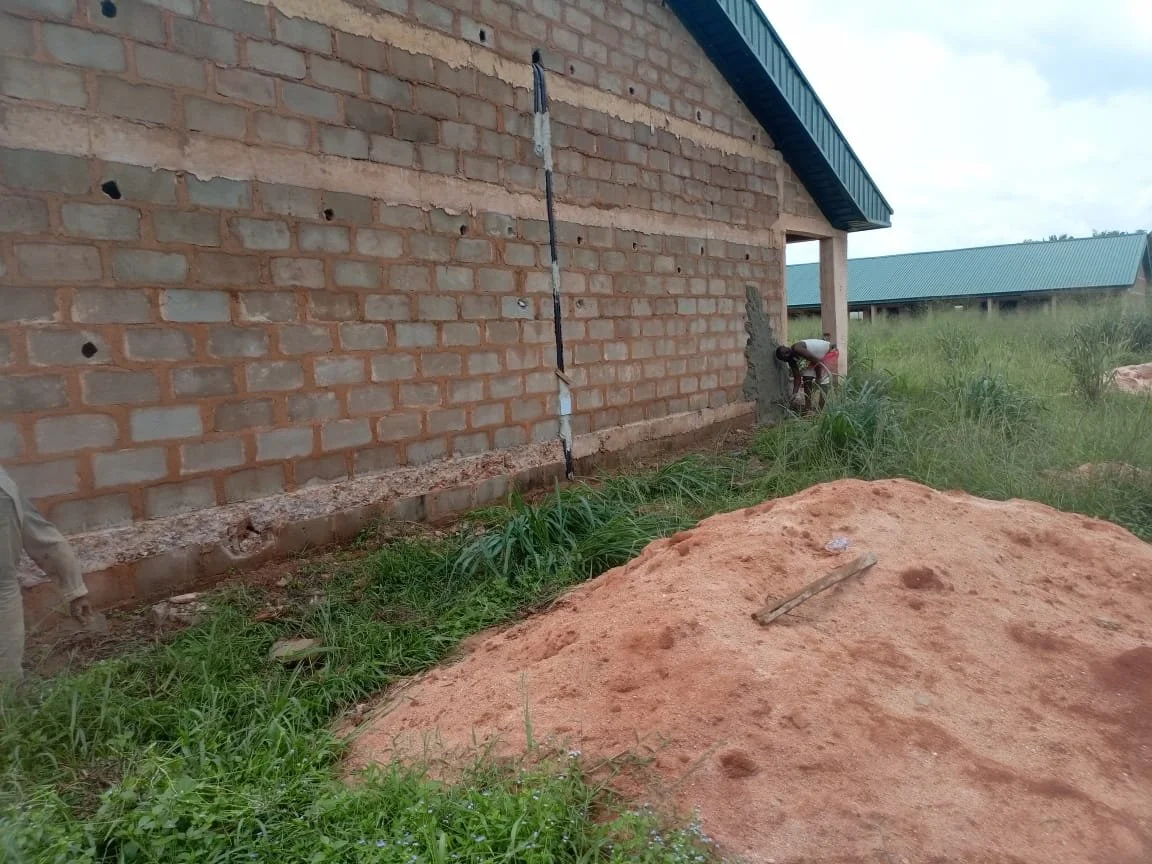

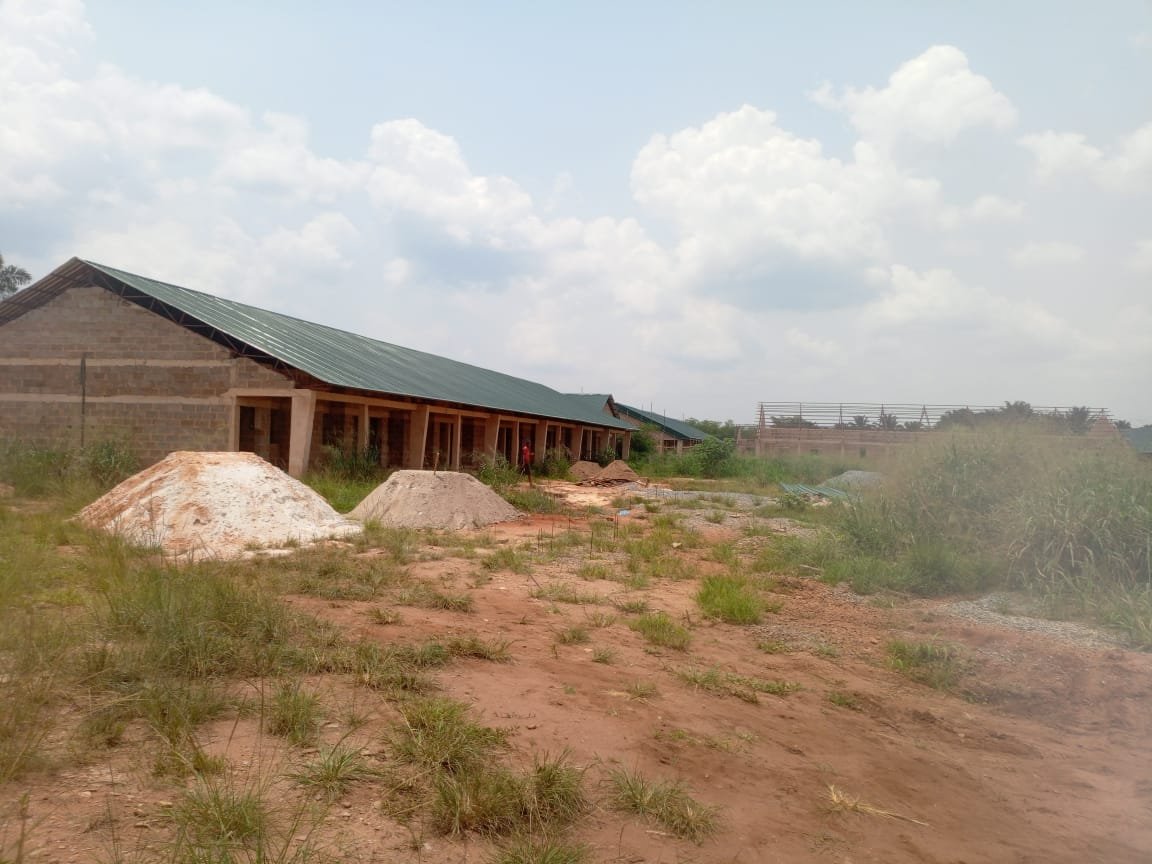

Library already at roofing level, block work completed.

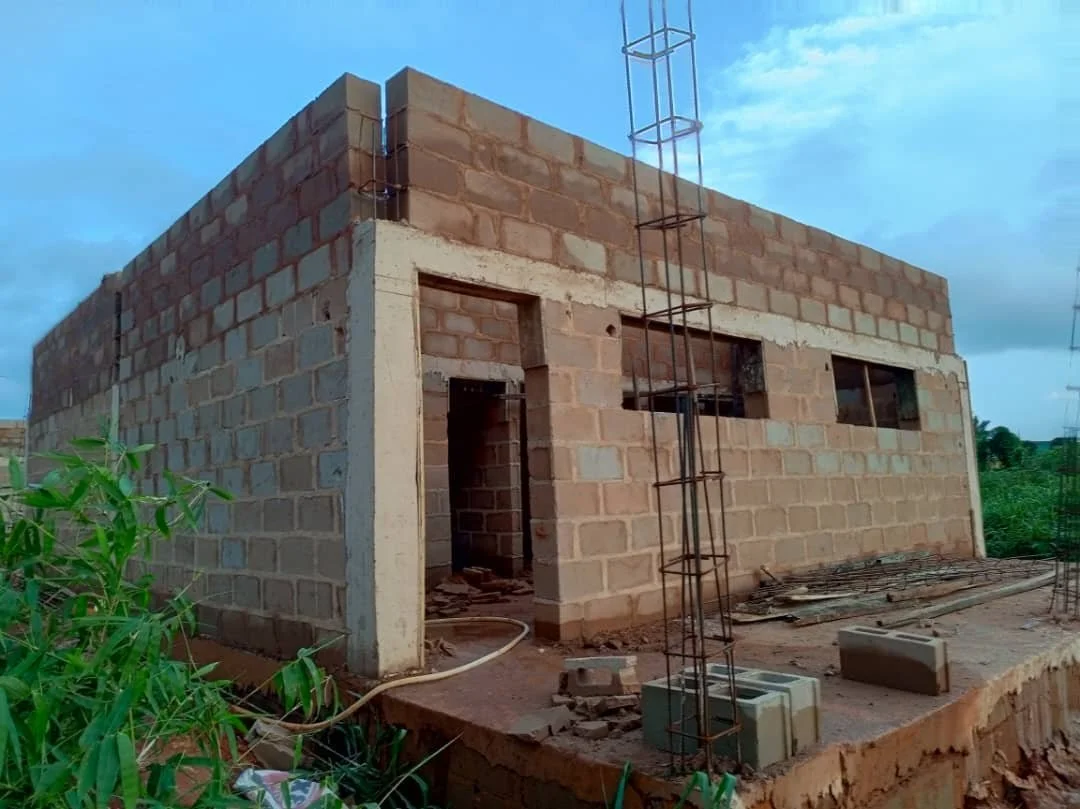

Second toilet from the left side. Block work completed as well.

Laboratory block still at foundation level because of swampy soil etc.

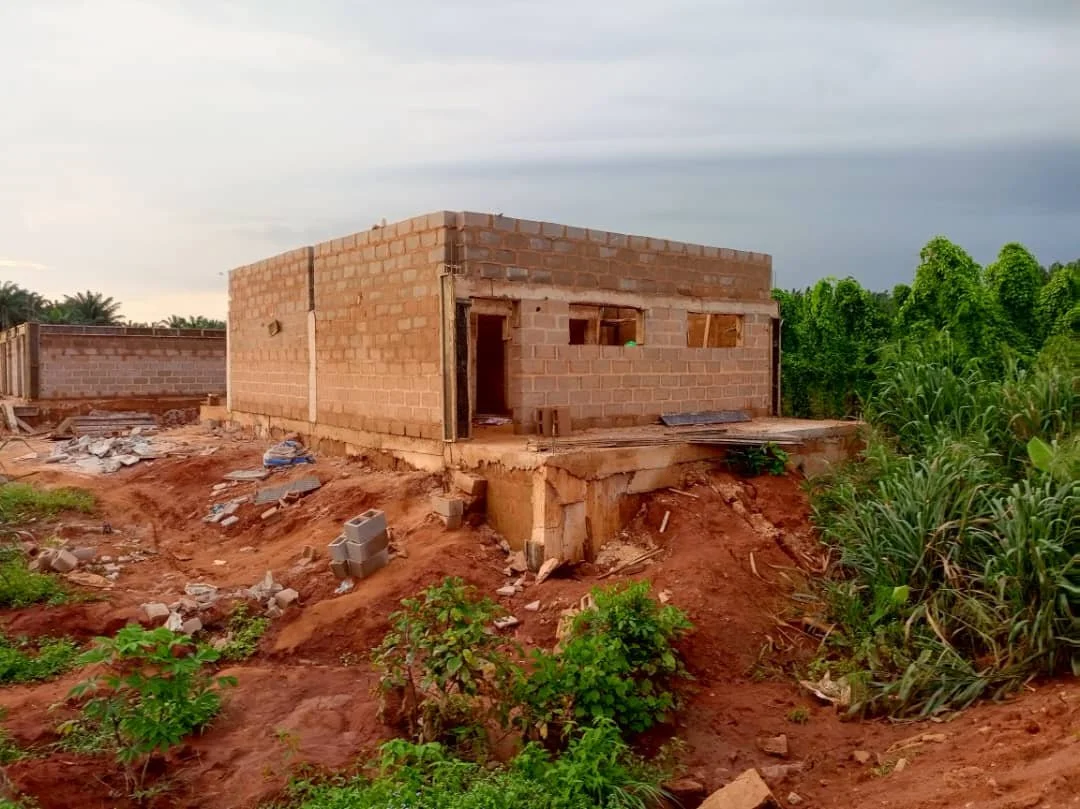

One of the toilet blocks, reached roofing level.
RECENT BUILDING DEVELOPMENTS

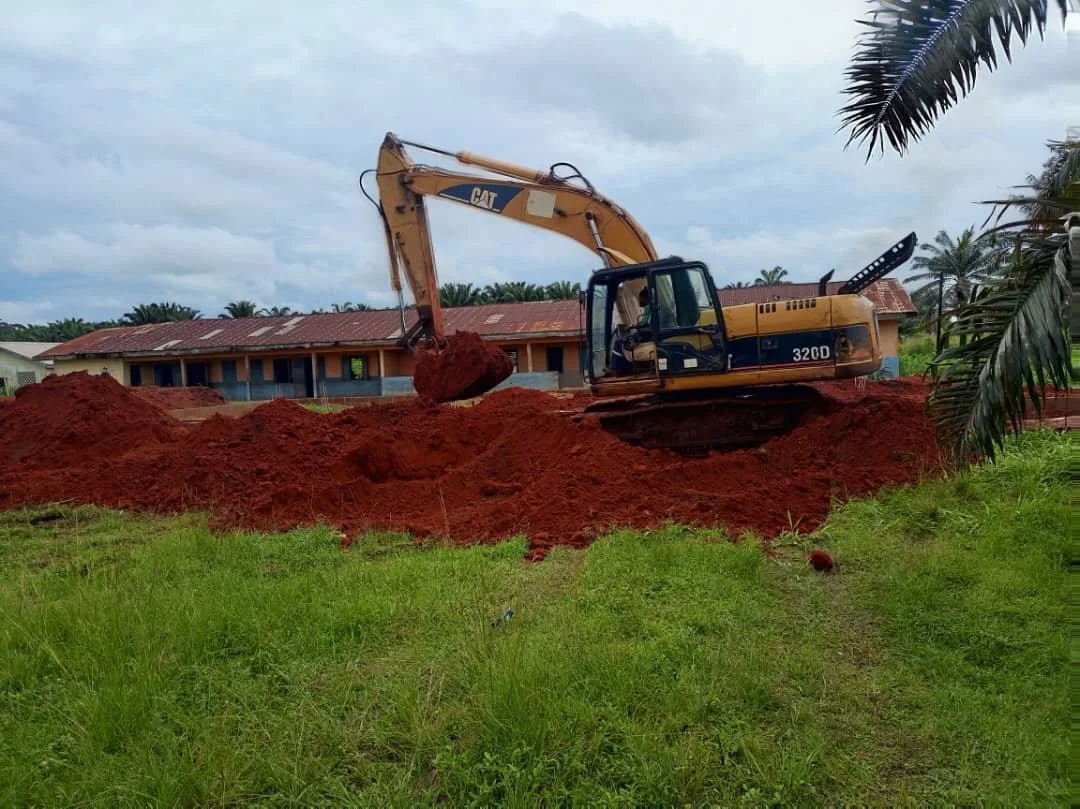

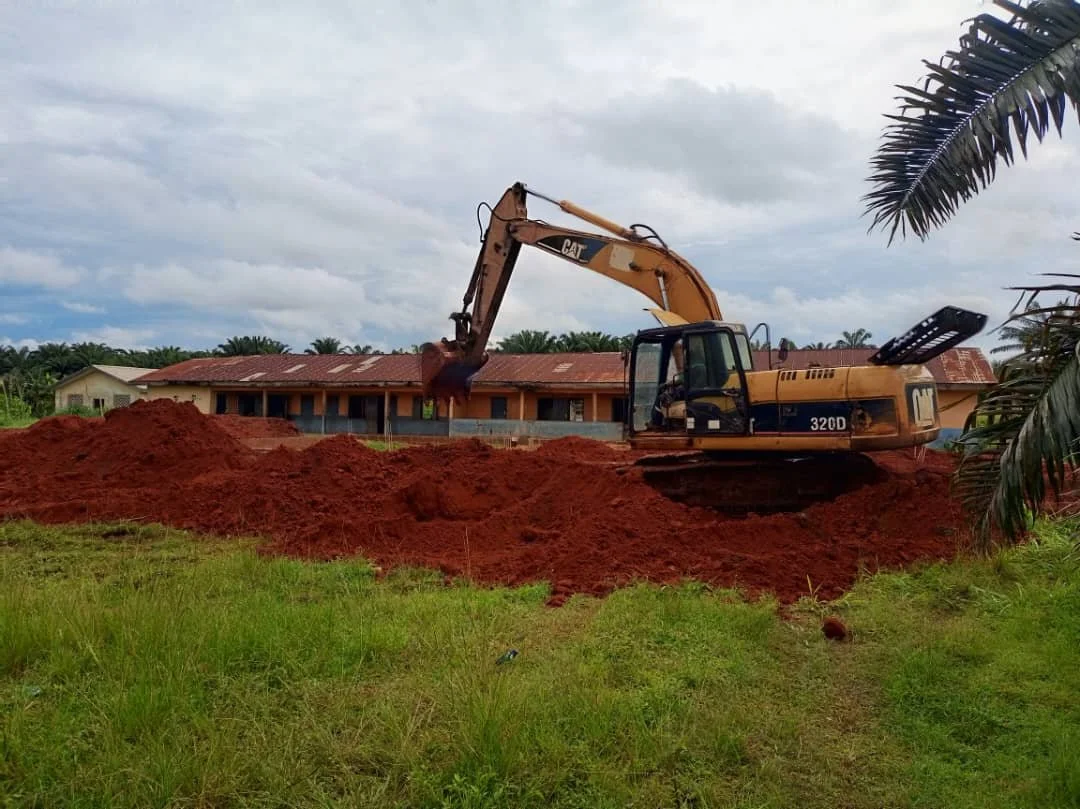

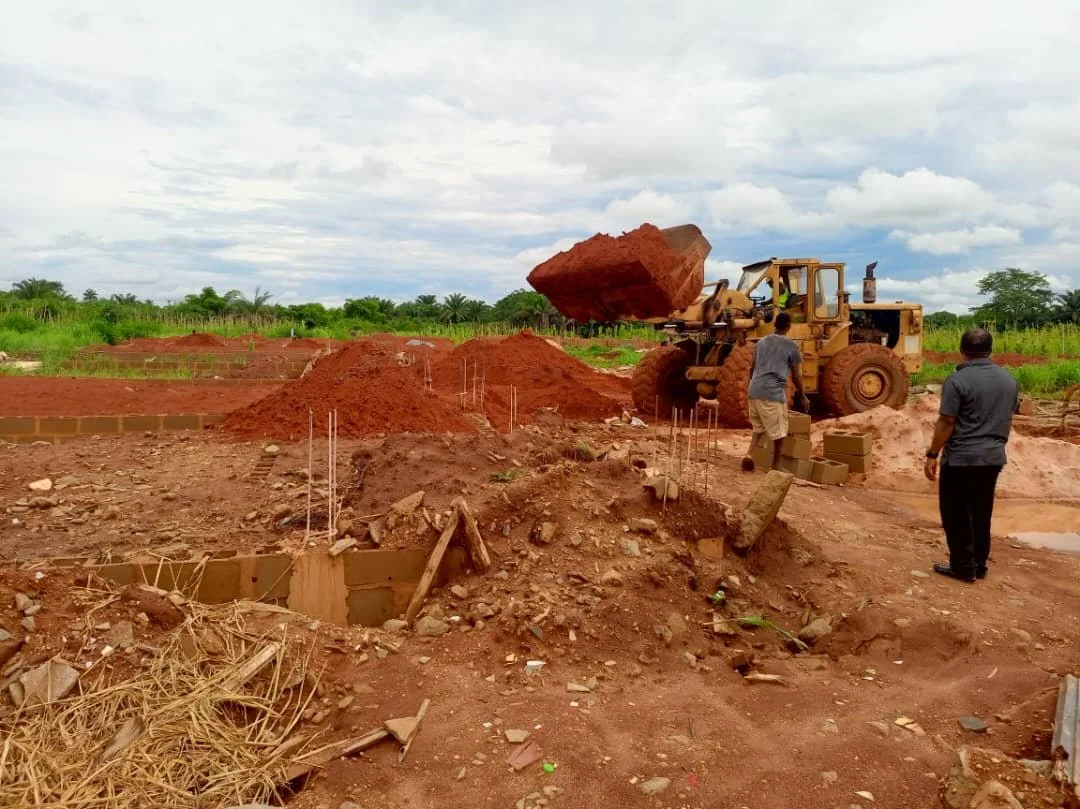

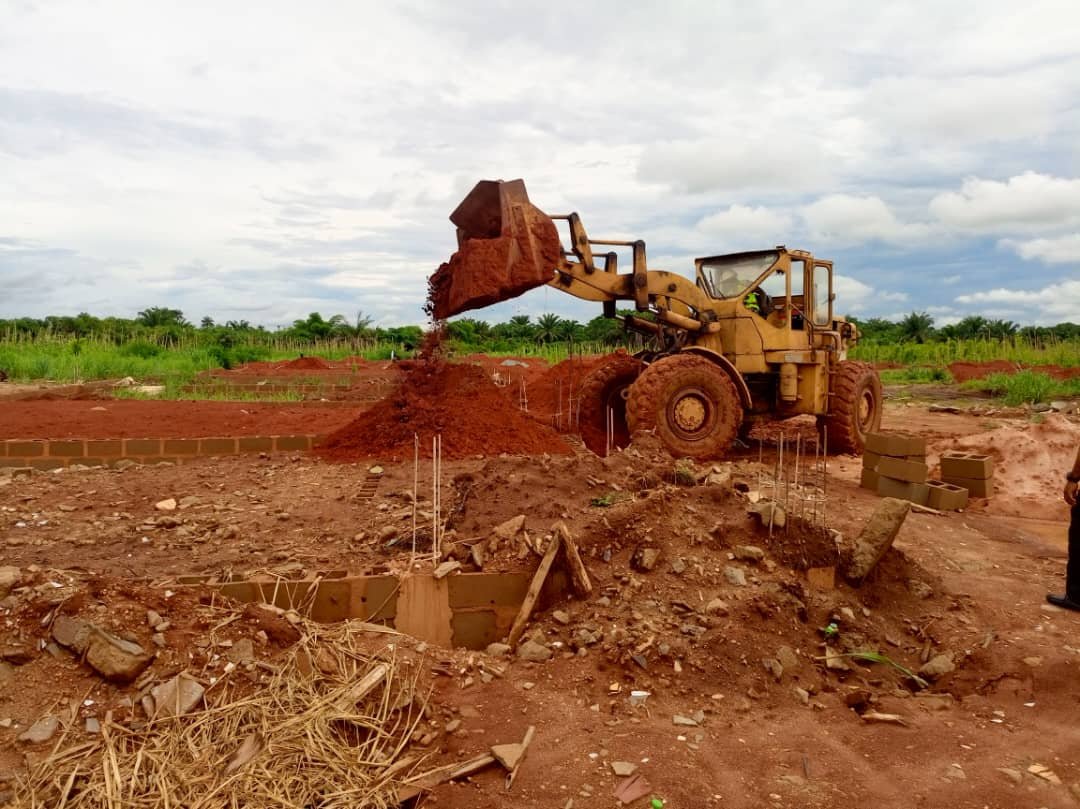

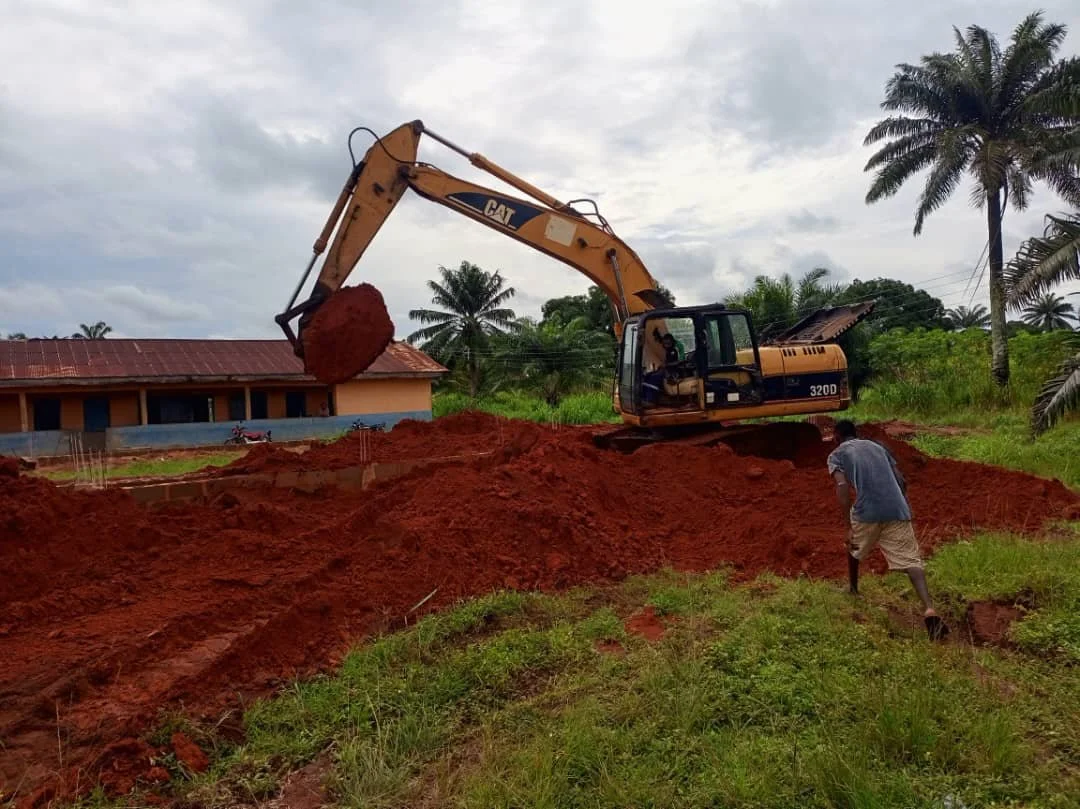

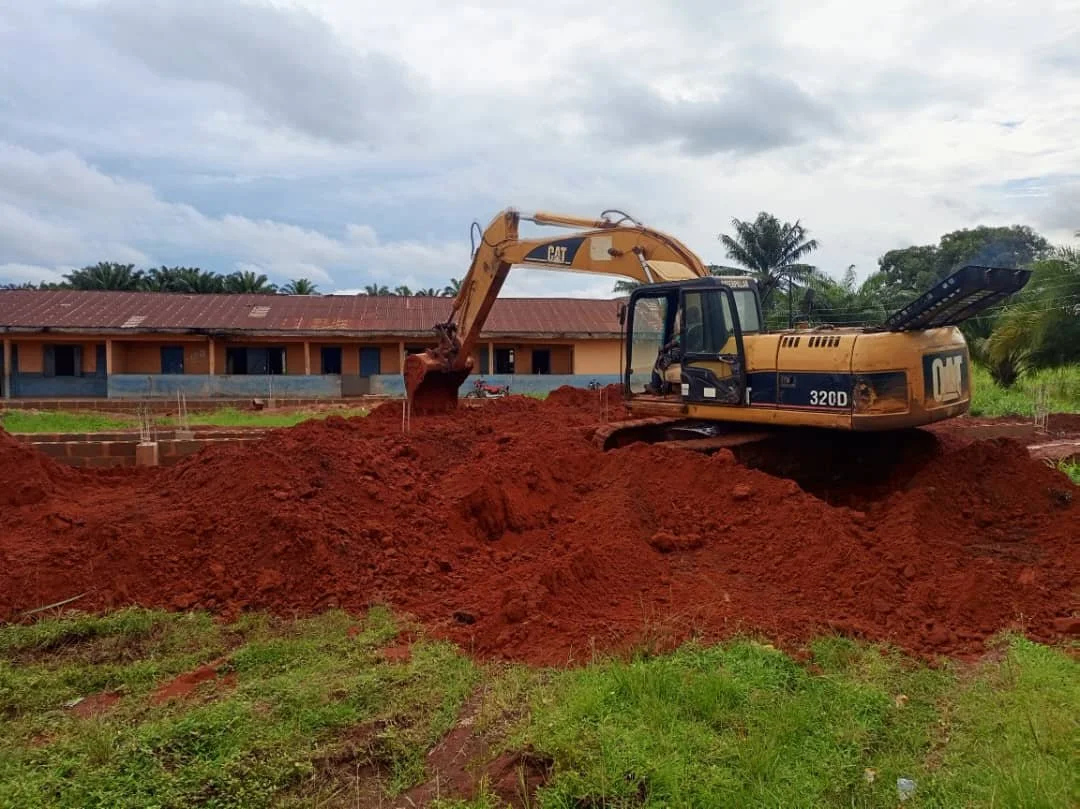

PALE LOADER AND EXCAVATOR FILLING THE FOUNDATIONS

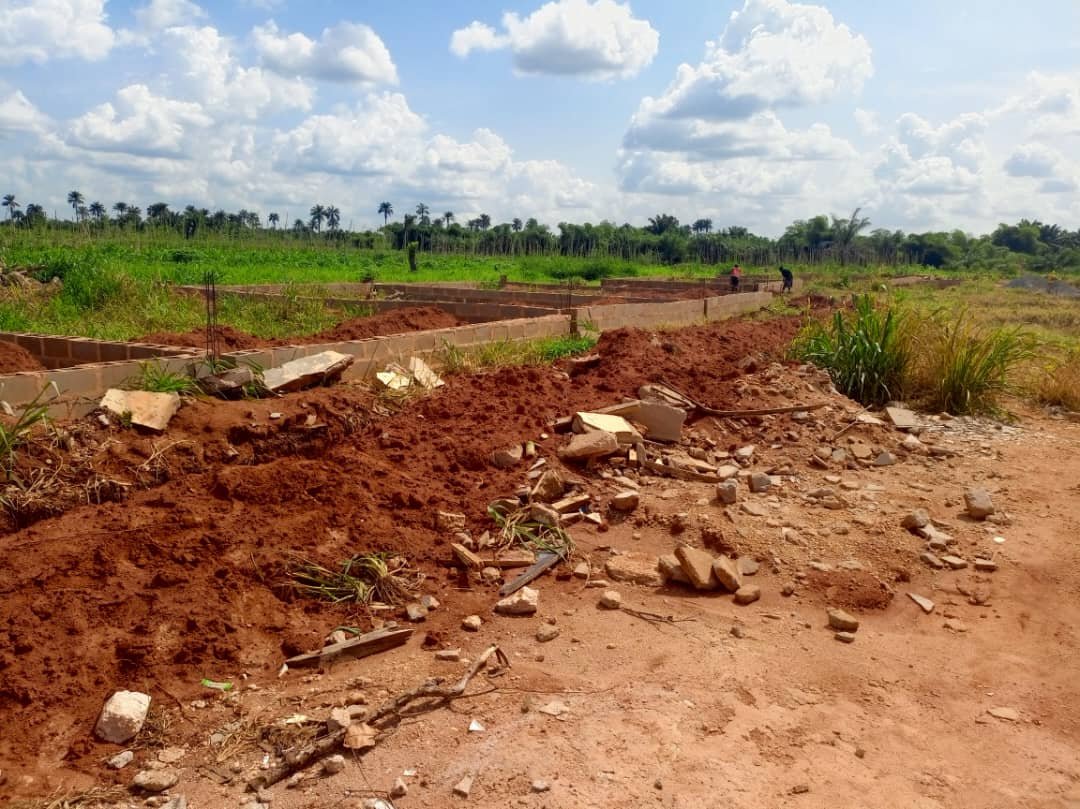

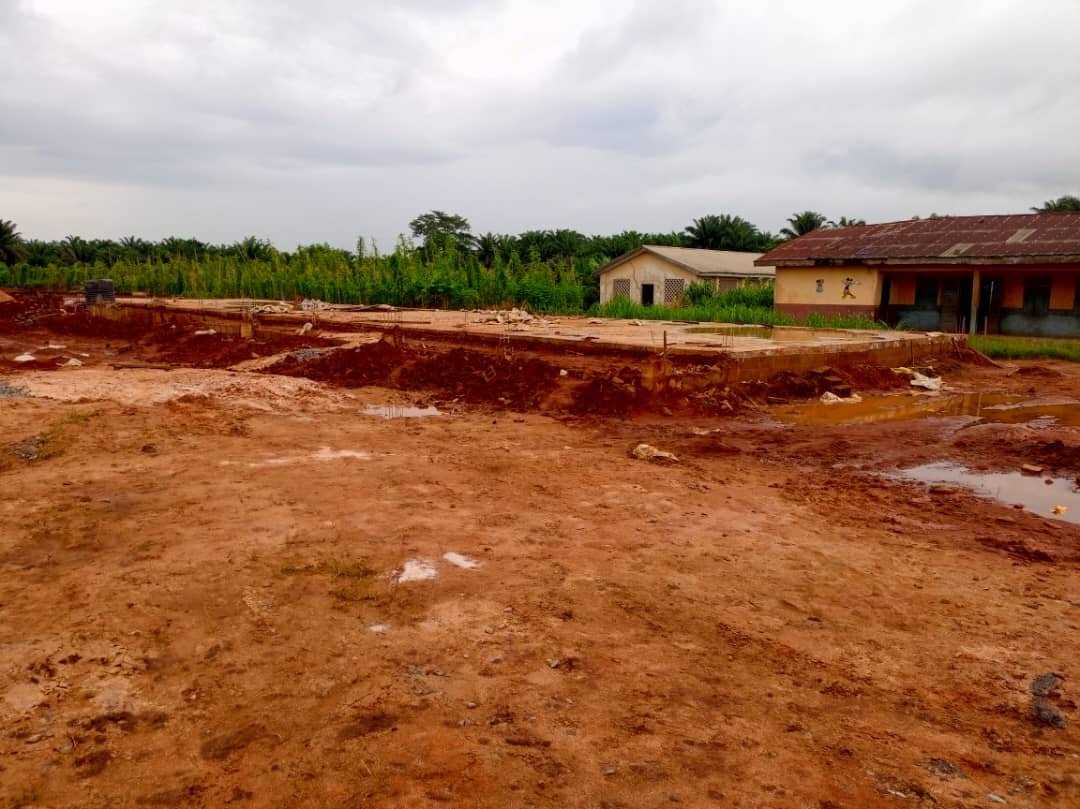

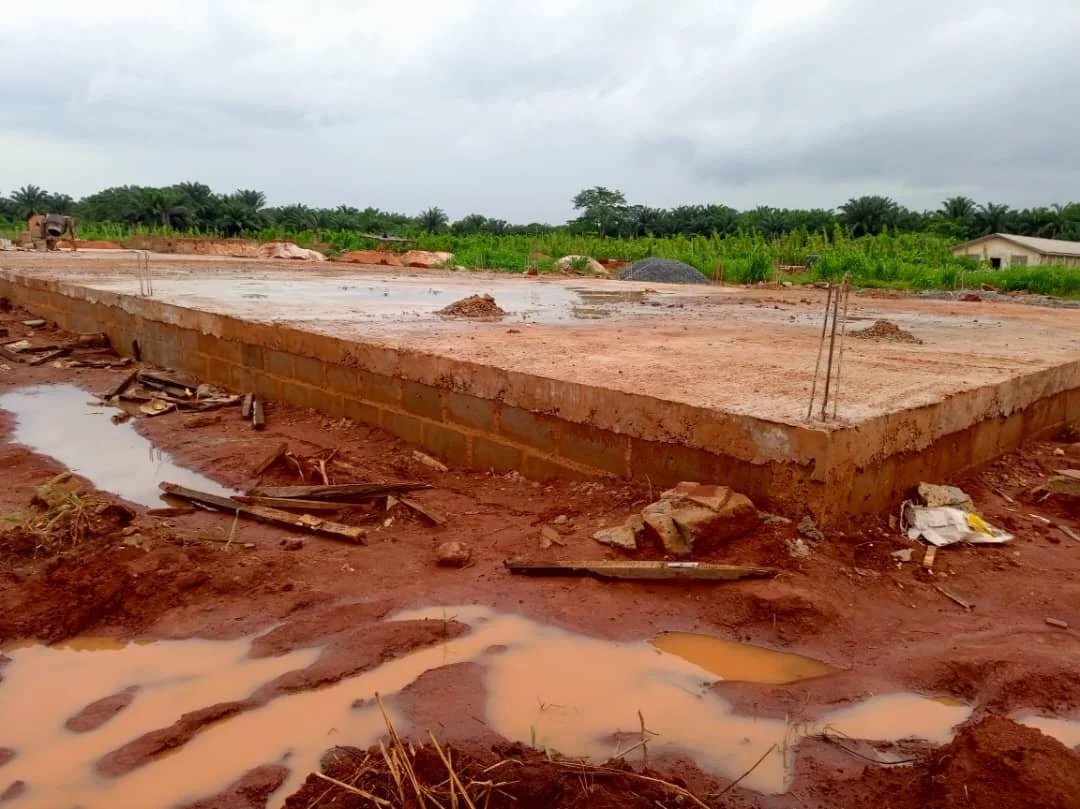

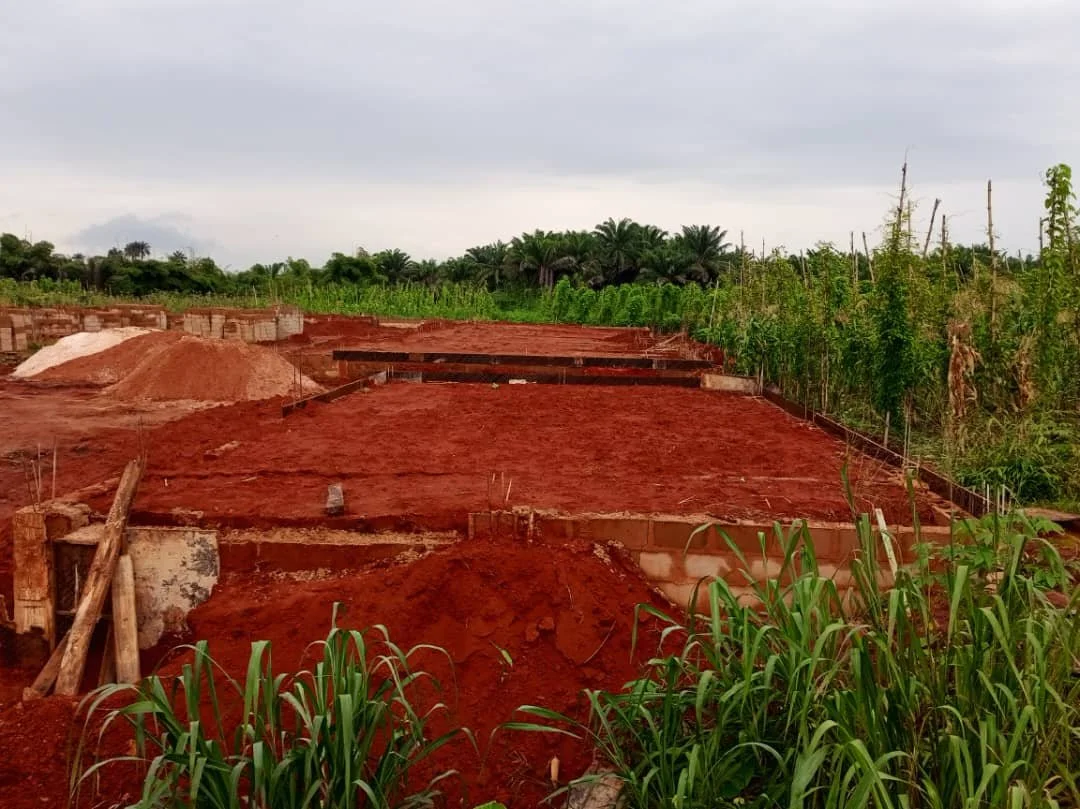

FOUNDATIONS FILLED AWAITING GERMAN FLOORING OR CONCRETE FLOORING

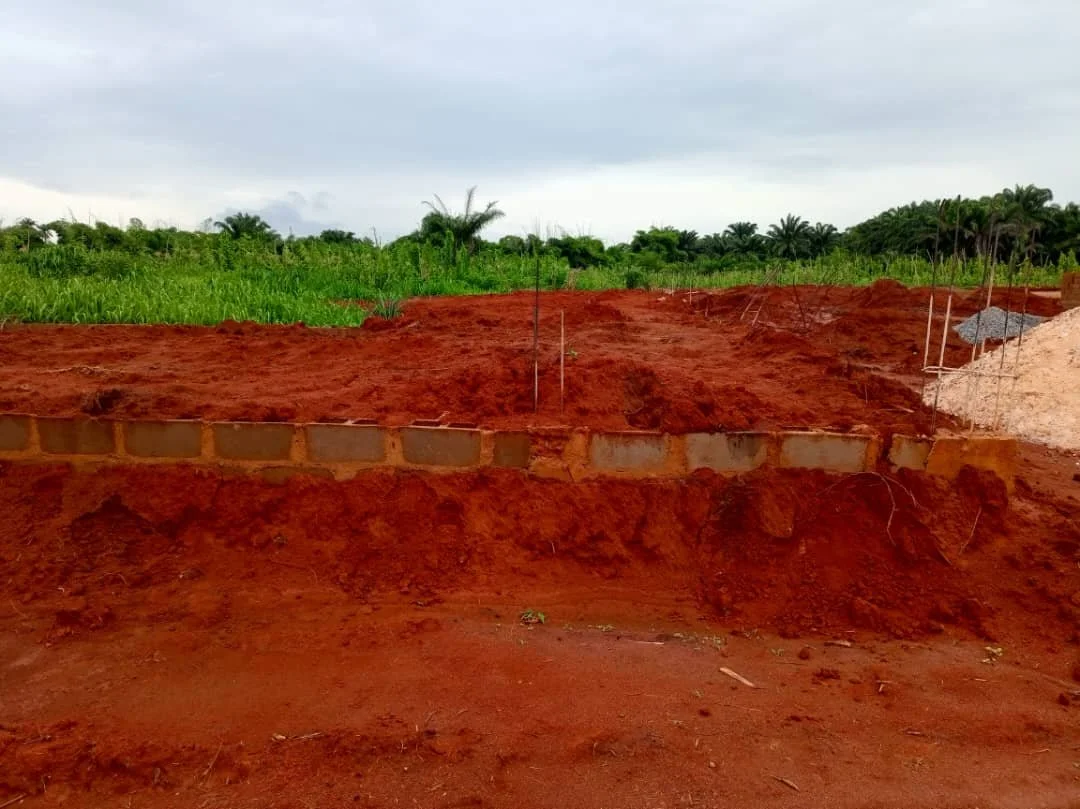

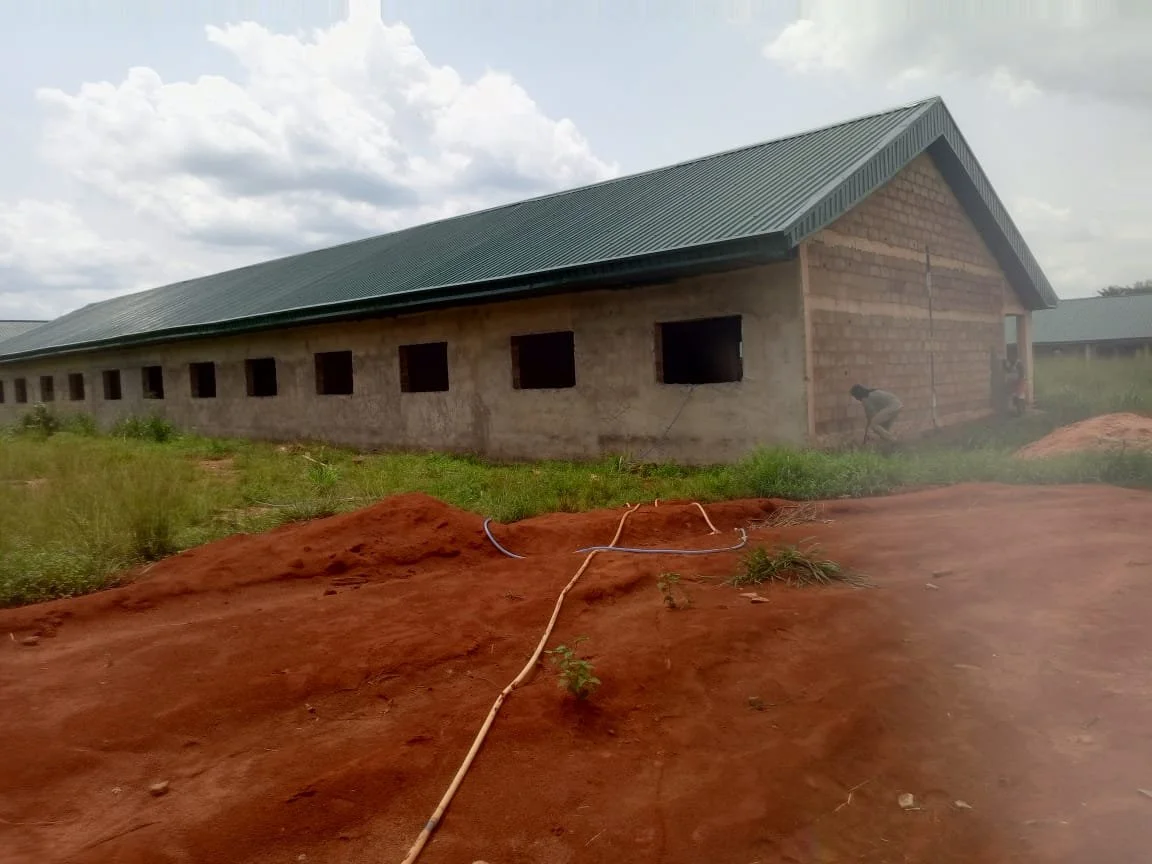

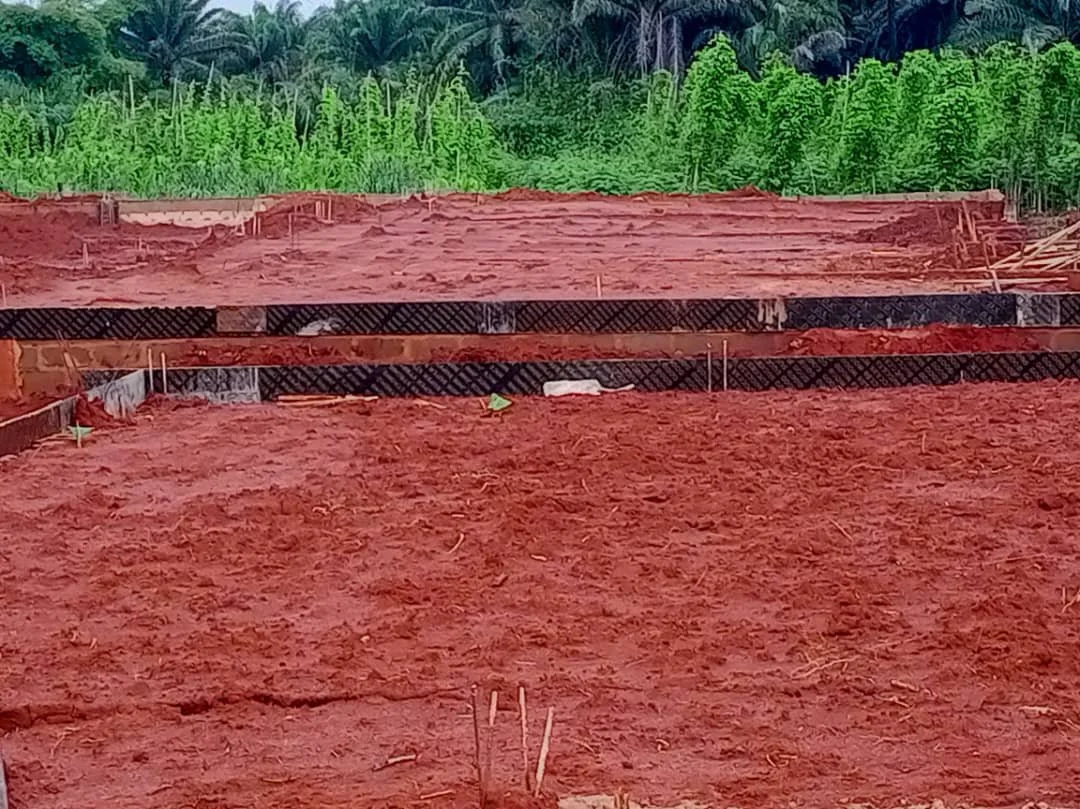

GERMAN FLOOR OF THE THREE BLOCKS COMPLETED
The project is going on, though at the foundation level for:
8 Blocks of 4 classrooms, 2 Toilets (one on each sides)
1 Laboratory and a Block for the Library
Excavation is yet to be made for the ICT Laboratory and the Administration block.
BUILDING MATERIALS ARRIVES IN THE SCHOOL
Materials for the building of four blocks of six new classrooms, 2 blocks of convenience, one block of library, one block of laboratory, and a block for ICT have started arriving the school with the delivery of nine hundred bags of 50kg cement, rods, granite and planks for initial take off of the construction. On ground already is thirty thousand nine inches hollow block to ensure smooth flow of the work.
